Everything You Need to Know to Rescue a Struggling Software Project

A missed deadline or a buggy launch doesn’t always mean your project is broken. However, if your team is constantly falling behind, your app keeps crashing, or development progress has stalled, it might be time to look beyond temporary fixes. In many cases, what you need is a software project rescue.

In this post, you’ll learn how to tell the difference between a project that simply hit a bump in the road and one that’s heading toward failure. You’ll learn what IT software project rescue services include, how they differ from rebuilding or routine maintenance, and how to choose the right partner to bring your broken software project back on track.

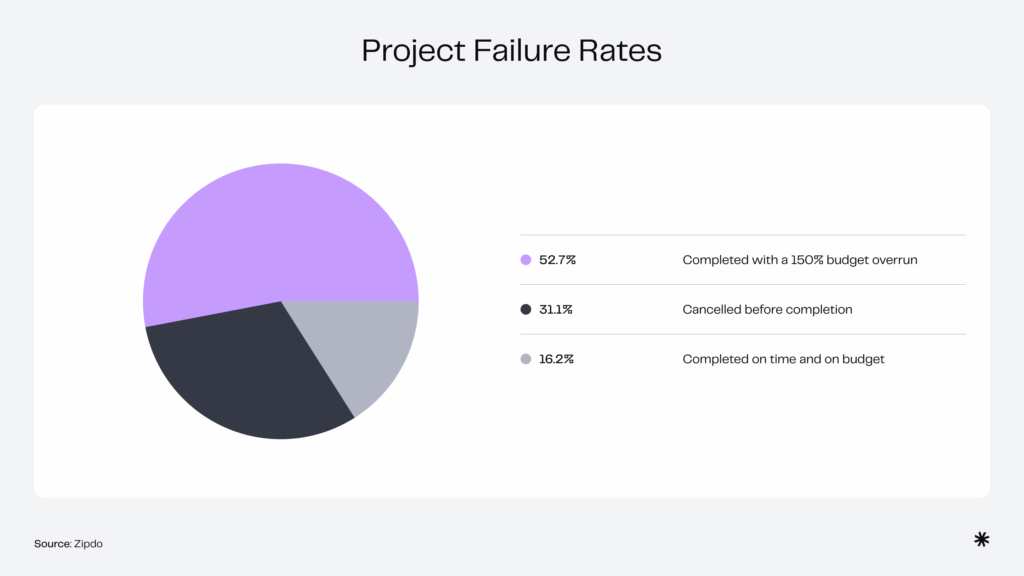

Pie chart showing software project outcomes: 52.7% over budget, 31.1% canceled, and 16.2% completed on time and within budget.

What is software project rescue?

Software project rescue is the process of stepping in to stabilize a struggling or failing software project and reset it onto a realistic, achievable path forward.

Its main goal is to take back control of a difficult situation and make smart, informed decisions quickly.

Here’s how that works:

  • Assess what’s salvageable. A rescue team conducts an audit to determine what can be reused, what needs rework, and what outcomes are still achievable.
  • Shift the goal from “on time” to “on course.” That means stabilizing the codebase, rebuilding trust among stakeholders, and delivering a version of the product that still supports the core business goal, even if timelines or scope must change.
  • Redefine budget and timeline realities. Rescue experts help decision-makers understand trade-offs: What features can be postponed or cut? What does an MVP look like? What’s the cost of recovery vs. cancellation?

Software project rescue services can be used for custom software, SaaS platforms, mobile apps, enterprise systems, and AI-based tools that are stuck, delayed, or off-track. They’re typically delivered by experienced software development partners or technical consultants who specialize in rescuing high-risk or mismanaged projects.

Important to know: Engaging a rescue team doesn’t automatically mean firing your current developers or canceling the troubled project. In many cases, the rescue effort supports or augments your existing team, offering fresh expertise, structure, and a clear path forward when momentum is lost.

Is your software project drifting off course?

Request a free consultation today, and get expert insight into what’s worth saving, what needs fixing, and how to move forward with confidence.

Talk to expert

Rescue projects vs. upgrade and maintenance work

Not every mid-project engagement qualifies as a rescue. While it’s common to bring in a new team to improve or extend an existing product, a true rescue means the project is in crisis: overdue, over budget, unstable, or drifting without direction. The goal isn’t just to build more features or fix bugs; it’s to stabilize the situation, recover lost value, and restore confidence without starting from scratch.

In contrast, maintenance or upgrade work deals with systems that are functional, live, and strategically sound, but need better performance, additional features, or stronger technical oversight.

Here are some examples to illustrate the difference:

Rescue project example #1: Stalled eCommerce launch

A B2C retail company spent 18 months building an eCommerce platform with a third-party vendor. Despite several testing rounds, the site never launched. Key integrations failed repeatedly, regressions piled up, and deadlines kept slipping.

Why it qualifies as a rescue:
The project was stuck, non-functional, and at risk of being cancelled. The goal was to recover, not to upgrade.

Rescue solution:
A new team steps in to run a fast-track audit, fix core integration issues, resolve critical bugs, and reach project completion—without rewriting the whole system.

Rescue project example #2: Overbuilt internal ERP

A manufacturing company commissioned an ERP system to automate inventory and vendor workflows. Halfway through the build, scope creep, team churn, and poor documentation left the system bloated, late, and difficult to use. After a year of effort, not a single module had been deployed.

Why it qualifies as a rescue:
The system had spiraled out of control. Delivery had stalled, business needs weren’t being met, and internal teams had lost clarity.

Rescue solution:
The new team re-scopes the MVP, strips out nonessential features, stabilizes core modules, and delivers a working release that aligns with actual workflows.

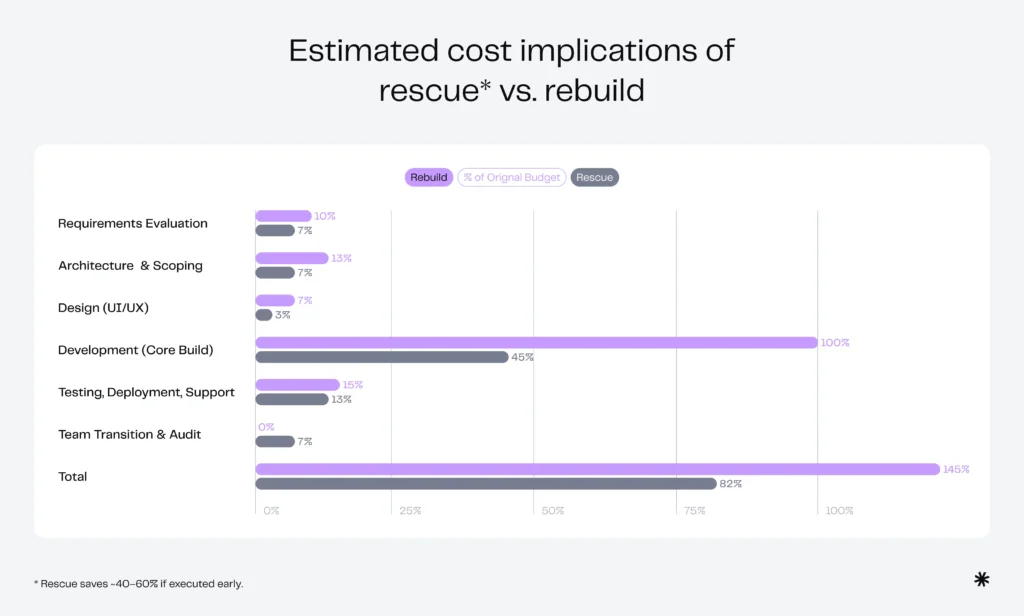

Bar chart comparing estimated cost percentages of software project rescue versus full rebuild across different development phases.

Rescue project example #3: Failing mobile app

A startup built a sales enablement app, but users found it unreliable and confusing. It crashed often, didn’t support basic offline use, and failed to integrate into reps’ daily workflows. User churn spiked, and stakeholder trust declined.

Why it qualifies as a rescue:
The product existed, but wasn’t viable. The business had a working codebase, but no user traction, no confidence, and a rapidly closing runway.

Rescue solution:
Technical professionals conduct a product audit, fix key architectural issues, redesign core flows, and relaunch with a tightly focused user journey targeting 3 high-impact scenarios.

Example of a non-rescue project

A SaaS company with a live, stable platform brings in a new team to extend reporting features, improve performance, and support a new integration layer.

Why this is not a rescue:
There’s no crisis. The product is live, in use, and delivering value. The team is there to execute a roadmap, not to reverse a failing trajectory.

The key difference is whether the project works or not. If it’s stuck, broken, or falling apart—it’s a rescue. If it works and just needs upgrades, it’s a matter of maintenance or improvement.

Knowing the difference helps ensure you choose the right team, set the right expectations, and align stakeholders around the real work ahead.

Not sure if your project needs a rescue?

Request a free technical audit to uncover the risks, bottlenecks, and opportunities hidden in your codebase. Our senior engineering team will review your current architecture, delivery process, and backlog, so you can make informed decisions about how to move forward.

Book an audit now

How to identify that the project needs software rescue services?

Recognizing when a software project is in trouble isn’t always easy, especially when teams are working hard and progress seems to be happening. But delays, uncertainty, or growing frustration are often signs of deeper issues. The earlier you catch them, the easier it is to course-correct.

Here are the most common red flags that signal the need for rescue services:

1. The project is significantly behind schedule

If deadlines keep slipping and there’s no clear recovery plan, it’s a warning sign. Rescue services will bring in outside experts to identify root causes, evaluate bottlenecks, and reset the timeline based on real constraints, not wishful thinking.

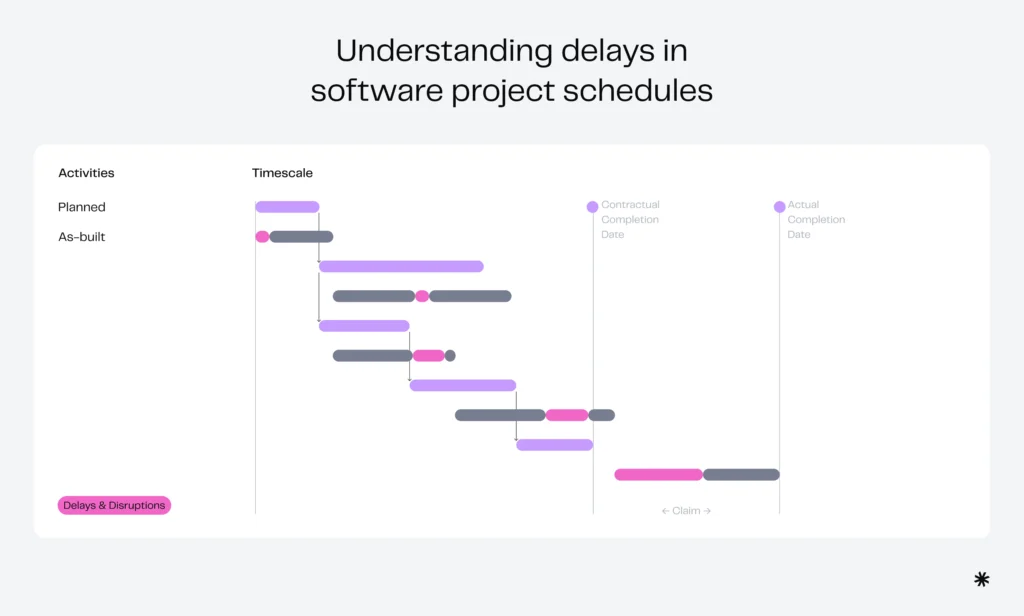

Gantt chart comparing planned vs. actual software project timelines, highlighting delays, disruptions, and missed completion dates.

2. Budget overruns without clear deliverables

When costs are rising but the product isn’t taking shape, leadership starts to lose confidence—and rightly so. A rescue team will help reconnect spending to outcomes, cut waste, and re-scope where needed based on business value.

3. Constant changes in scope or priorities

If requirements keep shifting, priorities are unclear, features are being built but not released or used, or there’s frequent internal disagreement about what the product should do, it’s a sign that the project has lost direction. A rescue team can help realign the development process with current business goals and re-establish a focused roadmap.

4. Frequent bugs, crashes, or quality issues

Bugs are normal, especially at the project start. But persistent crashes, poor performance, or instability after months of development often point to deep issues in the software architecture or codebase. A rescue team will audit the system, isolate critical flaws, and create a technical recovery plan.


Read also: Creating modern web app architecture


5. Team morale is low, or turnover is rising

Low motivation, lack of communication, or the departure of key engineers can stall a project completely. Rescue services can stabilize the team, fill skills gaps, and re-establish leadership to restore momentum.

How to create a software project rescue plan?

Once you’ve recognized the need for rescue, the next step is to build a clear, focused recovery plan. This is typically led by the rescue services provider—whether a development agency, consultancy, or specialized recovery team—in close collaboration with project stakeholders.

A good rescue plan doesn’t try to “finish everything as originally planned.” Instead, it aims to stabilize the project, restore stakeholder confidence, and deliver value within the constraints that now exist.

Here are the key steps you should expect in the rescue planning process:

1. Current project state audit

The rescue provider will conduct a comprehensive audit of:

  • The codebase (quality, structure, maintainability)
  • Architecture and tech stack (suitability, scalability, risks)
  • Project documentation (requirements, test cases, user stories)
  • Team workflows (DevOps, CI/CD, version control)
  • Delivery status (what’s been built, what’s working, what’s not)
  • Project management health (backlogs, sprints, timelines)

As the client, you should expect a current state assessment report summarizing:

  • The state of the project vs. original plans
  • Key technical and delivery risks
  • Immediate blockers
  • High-level recommendations (to be refined later)

This audit forms the foundation for deciding whether to proceed with the same provider, and for aligning your internal team around the true state of the project.

2. Revalidate product-market fit before building anything

A rescue isn’t just about code and delivery; it’s about making sure you’re solving the right problem. Interview users. Analyze active usage. Identify the actual workflows your product supports. Make sure what you’re rescuing is worth saving.

3. Identify what’s salvageable

Using input from your internal team, the rescue provider will determine what parts of the project can be reused, what can be refactored or stabilized, and what needs to be replaced or discarded.

They will look for:

  • Stable code that can be reused
  • Features that meet current business needs
  • Any documentation, test coverage, or infrastructure that can be leveraged

The goal is to protect past investments and avoid unnecessary rework.

Your internal team should take an active role in this step by providing essential business context. The rescue team can assess technical quality, but they won’t always recognize which components are mission-critical, compliance-related, or contractually promised to customers.

For example, a messy-looking module might still be essential to a regulatory workflow or a key client integration. Without that insight, there’s a risk the rescue team could mistakenly recommend discarding something that must be preserved.

The deliverable is typically a Salvage Evaluation Report (could be named differently, though) that includes:

  • Inventory of reusable assets
  • Risk and gap analysis
  • Recommendations for rework or removal

Get detailed evaluation from experts

Schedule a free consultation with senior engineers to analyze your codebase, infrastructure, and delivery pipeline. We’ll pinpoint what’s reusable, what’s risky, and what to fix, so you can move forward without wasting time or budget.

Book a consultation now

4. Re-align the project with business goals

This step defines what the project is now trying to achieve. Often, the MVP or core deliverables are re-scoped based on updated budget, timeline, and user needs.

This may involve:

  • Cutting non-essential features
  • Reprioritizing based on business impact
  • Adjusting the delivery strategy

The rescue team will guide this process, asking the right questions, mapping technical feasibility, and proposing options. But alignment depends on input from product owners, CTOs, and business leads, who clarify success criteria and approve trade-offs.

5. Build a realistic recovery plan

The rescue team will translate findings into a lean, time-boxed delivery plan that includes:

  • Clear milestones and short-term goals
  • A reduced, validated scope
  • Revised timelines and budgets
  • Defined team roles and accountability

Note: This is not the “how it should have been” version of your original development plan. That plan was built for a different moment, with different assumptions. You’re not starting from zero anymore, and conditions have changed.

A recovery plan is fundamentally different: it focuses on stabilization, risk reduction, and outcome-driven delivery under new constraints.

6. Rebuild stakeholder alignment and communication

Even with all the right methods—stand-ups, retros, reports—projects can still fail if communication doesn’t match stakeholder expectations or culture.

The rescue team will:

  • Review previous communication workflows
  • Propose a new cadence (e.g., weekly demos, executive updates)
  • Create shared dashboards for real-time visibility
  • Recommend tools for more transparent project tracking
  • Designate clear points of contact for feedback and decisions

They’ll also help the team deliver “quick wins”: small but visible progress milestones to rebuild trust and morale early in the process.

7. Stabilize the team and execution environment

As a final step, the rescue team may recommend structural or operational changes to enable smoother execution. This could involve:

  • Bringing in missing talent or technical specialists
  • Reassigning or clarifying leadership roles
  • Strengthening accountability
  • Improving tooling, environments, or DevOps pipelines

The goal is to create an environment where the team can deliver consistently and confidently, even under pressure.

Who should build the rescue plan?

The rescue plan is typically created by the service provider. They have the experience and objectivity to assess and recover the project.

However, a successful rescue plan isn’t built in isolation. It requires close collaboration between the provider and your internal stakeholders.

Here’s how the roles usually break down:

RoleResponsibility
Rescue providerLeads the audit, reviews the codebase, identifies technical risks, evaluates team capacity, and proposes the new roadmap.
Product owner / Internal sponsorDefines business priorities, clarifies success criteria, and approves trade-offs between scope, time, and budget.
CTO / Technical leadAligns the rescue provider’s recommendations with internal systems, compliance needs, and future architecture plans.
Project manager (if applicable)Coordinates internal communication, manages timelines, and ensures that expectations are realistic and tracked.

Why the provider should lead

  • They bring fresh perspective and technical objectivity
  • They have experience with similar rescue scenarios
  • They can move quickly without being attached to past decisions or team politics

Why your involvement still matters

Even the best rescue team can’t define what success looks like for your business. Your team needs to provide:

  • Context (why the project matters)
  • Constraints (budget, timeline, stakeholders)
  • Vision (what a “rescued” version should accomplish)

Think of the provider as the lead architect of the rescue plan, and your team is the owner of the project outcome. When both sides are aligned, the rescue is faster, cleaner, and more likely to succeed.

Tips for implementing a rescue plan

Once the recovery plan is in place, the focus shifts from planning to executing under pressure, with limited time, limited budget, and often low stakeholder confidence.

Unlike implementing a typical software development plan, which is forward-looking and growth-oriented, implementing a rescue plan is about rebuilding trust and recovering value. You’re implementing it after failure, working around inherited technical debt, and navigating skepticism from both the team and stakeholders.

It’s not the easiest setup to work in, so here are some tips:

1. Treat it like a new project

Yes, a rescue plan isn’t a brand-new project started from scratch. But treating it like a new project helps prevent slipping back into the patterns and assumptions that led to the failure in the first place.

Treating it like a new project means:

  • Reframing expectations with stakeholders
  • Resetting the plan (scope, timeline, budget)
  • Clarifying roles and goals
  • Rebuilding trust in the process

It creates psychological separation from the failure, while still building on what’s already there: existing code, infrastructure, business context, and often a partially intact team.

2. Deliver a quick win

When trust is low (and it usually is after a failure), it’s critical to demonstrate early that the new plan is working.

The most effective way to do that is to deliver something visible and useful as soon as possible. It doesn’t have to be a new feature. A quick win might be:

  • Fixing a recurring bug that breaks staging or production
  • Automating a painful manual process (e.g., test runs, CI/CD)
  • Increasing test coverage in critical paths

To identify a meaningful quick win, ask:

  • What’s slowing the team down the most?
  • What are stakeholders most frustrated by?
  • What’s the issue we keep patching instead of fixing?
  • What small fix could unlock bigger gains next month?

Choose a target that can be completed in 5–10 days and delivers a measurable result, whether that’s a faster deployment, fewer support tickets, or more reliable staging.

And don’t be modest: highlight the win, however small. Visible progress builds confidence and clears the path for more meaningful results.

3. Document shortcuts

In rescue mode, you’ll often need to prioritize speed. That may mean taking technical shortcuts, and that’s okay, as long as they’re tracked and reviewed.

Whenever a shortcut is taken—skipped tests, hardcoded logic, bypassed abstractions—it should be:

  • Logged as a technical debt item
  • Clearly tagged in the code (e.g., // TEMP FIX – Replace with config-driven logic)
  • Documented in your backlog or ticketing system (e.g., Jira, Linear)

Consider creating a dedicated “tech debt” label or board and include for each item:

  • What was compromised
  • Why the shortcut was taken
  • Recommended follow-up
  • (Optional) When it should be reviewed or addressed

Make tech debt review part of sprint retros or planning sessions. Also, define a lightweight policy that clarifies what’s acceptable to defer and what’s too risky to ignore, so teams don’t rely on guesswork or make silent trade-offs.

It sounds more complex than it is. For example, if your team skips tests for a new module to meet a deadline:

  • Create a Jira ticket: “Backfill unit tests for XYZ module”
  • Add a code comment: // TODO: Add tests after initial release
  • Include it in the next retro and estimate it
  • Flag it in a tech health review

Now it’s tracked, visible, and won’t be forgotten.

4. Have an exit strategy

Every rescue plan needs a clearly defined endpoint, defining what success looks like and what failure means. This protects the team and leadership from endless investment in a project that may no longer be viable. It also builds confidence by making progress measurable and decision points clear.

A strong exit strategy should:

  • Define what “done” looks like (e.g., MVP delivered, stability restored)
  • Define what “dead” looks like (e.g., no user engagement, technical recovery too costly)
  • Set a review timeline or checkpoint (e.g., after 8 weeks or 3 sprints)
  • Establish who owns the final go/no-go decision

With an exit strategy, the rescue becomes a disciplined, time-boxed effort and not an emotional one.

Need help implementing a recovery plan?

Partner with an experienced rescue team to stabilize delivery, unblock your roadmap, and restore stakeholder confidence. We’ve led high-pressure recoveries across SaaS, mobile, and enterprise systems—and we know what works.

Schedule a call

Rescuing a project vs. rebuilding

Rescue means stabilizing, fixing, and completing the existing project. It assumes that at least some portion of the current work is technically sound, aligned with business goals, and worth preserving (due to sunk cost, time, or compliance reasons).

A rescue effort focuses on:

  • Auditing and refactoring what’s already built
  • Cutting or re-scoping non-essential features
  • Solving critical quality, architectural, or process issues
  • Rebuilding stakeholder confidence

The goal of rescue is to recover value from what already exists without starting over.

Rebuilding means discarding the current codebase and starting fresh, often with a new architecture, team, or tech stack.

It’s the right choice when:

  • The existing system is fundamentally flawed (e.g., unscalable, insecure, unmaintainable)
  • Business requirements have changed significantly
  • Technical debt is too high to justify salvaging
  • The project lacks clear ownership or strategic direction
  • Stakeholder trust is beyond repair

The goal is to restart under better conditions with a new plan, team, and mindset.

Key differences between rescuing vs. rebuilding a software project

AspectRescueRebuild
Starting pointIncomplete or broken productBlank slate
FocusFixing and delivering existing workStarting fresh with better structure
CostLower upfront, may increase over timeHigher upfront, cleaner long-term
Time to valueFaster if salvageableLonger, but may be more sustainable
RiskUnknown issues in legacy codeClassic build risks, but more control
When it works bestWhen core value is intactWhen the old system is a liability

Key qualities of a skilled project rescue team

Contrary to what you might assume, not every high-performing development team can lead a rescue. Rescuing a failing project is fundamentally different from starting a new one. It requires more than just technical know-how; it calls for crisis management, fast decision-making, and tight alignment with business goals.

Here are the key qualities to look for in a capable rescue team:

1. Technical knowledge of complex systems

A strong rescue team must be able to quickly assess an unfamiliar, unstable, or poorly written codebase, including legacy systems and half-built architectures. They must also make sound judgments about what can be kept, what should be refactored, and what must be discarded.

How to verify:

  • Ask for examples of systems they’ve inherited, audited, or refactored, not greenfield builds.
  • Look for experience in debugging, performance tuning, and deep refactoring, not just delivering new features.
  • Consider requesting a sample code audit or technical evaluation of a module in your project.

2. Strong diagnostic and assessment skills

Rescue projects require teams that can quickly identify root causes and distinguish between technical, organizational, and process-level failures.

How to verify:

  • Look for evidence of structured methodologies (e.g., scoring systems, checklists, code reviews).
  • Consider giving a small test task during the conversation to see how quickly they can identify risks or bottlenecks.

3. Cross-functional thinking

Rescue projects often span engineering, product, QA, design, and executive leadership. A capable rescue team understands how technology, workflows, and business outcomes connect.

How to verify:

  • Ask about the business impact of their past rescue work.
  • Involve product or business leaders in the interview and observe how the team communicates.
  • During any live task or discussion, note whether they ask about users, workflows, or product goals, not just architecture or code.

4. Comfort with ambiguity

Most rescue projects come with missing documentation, shifting requirements, and vague ownership. A strong rescue team must be able to fill in the gaps and move forward without waiting for perfect clarity.

How to verify:

  • Ask about their experience inheriting legacy or mid-flight projects.
  • Observe how they respond to incomplete or unclear inputs during early discussions.
  • Good candidates will show confidence in navigating uncertainty without becoming blocked by it.

How to find a software project rescue company

Finding the right team to rescue a failing digital project is a high-stakes decision. You’re not just hiring a dev shop; you need a partner you can entrust to stabilize your investment and protect your reputation.

While the specific search process may vary depending on your business, product, or industry, here’s a practical framework for finding capable rescue teams:

1. Choose your sources

Focus on sources that prioritize track records, transparency, and endorsements from companies similar to yours. These could be:

  • Referrals from partners, advisors, or peers who have gone through a rescue project
  • B2B directories like Clutch, GoodFirms, or DesignRush. Look for categories like “software rescue,” “project recovery,” or “technical audits.”
  • Technical and founder communities like Indie Hackers, CTO Craft, SaaStr, and relevant Reddit threads. These often surface less visible but highly capable software project rescue companies.
  • Search engines and blogs: look for firms that actively write about legacy modernization, takeovers, or product stabilization; thought leadership often correlates with process maturity.

2. Shortlist based on recent relevant experience

Even though an agency claims to offer project recovery, it might not actually have real, recent, and relevant experience. When reviewing portfolios, case studies, or testimonials, focus on teams that have handled:

  • Mid-project takeovers
  • Incomplete builds or unstable MVPs
  • Codebase audits and remediation
  • Replatforming or modernization of legacy systems
  • Scaling prototypes into production-ready releases

Look for language that acknowledges complexity, failure modes, or architectural cleanup.

3. Contact candidates and assess their collaboration style

You need a partner who brings clarity, structure, and honesty. Early conversations are your chance to test that. Ask:

  • Have they taken over a broken or abandoned project before? What went wrong, and how did they approach the rescue? Listen for specifics, not just polished outcomes.
  • Have they ever advised a client to pause, pivot, or shut down a project? This shows they’re capable of protecting your investment, not just selling services.
  • What does their audit and onboarding process look like? Look for a structured methodology, collaborative inputs, and attention to business context.
  • How do they manage communication and reporting? Ask about reporting cadence, tools used (dashboards, tickets, demos), how they handle change requests, and how they ensure visibility across stakeholder groups.

These discussions don’t need to be about your project specifically (at least not until you sign an NDA). At this stage, you’re validating their process thinking, experience under pressure, and communication discipline.

Syndicode: when you need more than just a dev team

Rescuing a software project takes a team that can walk into a chaotic environment, make fast sense of what’s broken, and build a clear path forward without starting over. That’s where Syndicode stands out.

In projects like Le New Black, we inherited an existing codebase, stabilized it, improved performance, and helped the client move forward with confidence. With Maxwell, the Syndicode team stepped in to audit, optimize, and extend a real-time logistics platform that had stalled in development. And with Fuzu, we supported a live, high-traffic job-matching platform by resolving technical debt, improving scalability, and aligning delivery with user needs.

These builds are strategic interventions where timing, experience, and judgment matter just as much as code.

So, if your project is off track, the Syndicode team can help you figure out what’s worth saving, what to improve, and how to deliver results fast, without reinventing everything.

Contact us to get a personalized rescue plan for your software project.

Frequently Asked Questions

  • What is project rescue and how can it help my software project? Arrow right

    Project rescue means stepping into a struggling or failing software project to bring it back on track. It helps identify what went wrong and creates a realistic plan to fix it.
    The main thing about software rescue is that, instead of starting over, rescue specialists stabilize your existing codebase, rebuild confidence among stakeholders, and deliver working results. The goal is to recover value from the work you’ve already done, thus saving time and budget.

  • How do I know if my software project needs project rescue services? Arrow right

    If your project keeps missing deadlines, going over budget, or producing unstable releases, it’s a sign it may need rescue services.
    Other warning signs include low team morale, poor communication, constant scope changes, or unclear ownership. If you’ve lost confidence in your delivery process or can’t clearly say when or what will launch, it’s time for an external expert to assess the situation. A project rescue team can help identify root causes and create a clear recovery plan before things get worse.

  • What are the benefits of using a professional project rescue service? Arrow right

    Professional rescue teams bring structure, objectivity, and speed to failing projects. They know how to quickly diagnose problems, stabilize development, and realign delivery with your business goals. By leveraging proven processes and experienced engineers, you can restore stakeholder confidence, improve code quality, and ensure predictable progress. In short, it turns a project that feels risky or out of control into one that’s focused, stable, and moving toward measurable results.

  • How long does the project rescue process take and what are the costs? Arrow right

    The duration and cost of the project rescue depend on the size and complexity of your software. Typically, an initial assessment takes 2–4 weeks, followed by a recovery phase that can last several months. Smaller products may stabilize in weeks; larger systems often take longer.
    Costs vary based on scope, but the goal is always to control spending by fixing what’s valuable instead of rebuilding everything. If you have a project to rescue, contact our sales team for a clear personalized estimate.

  • What kind of support and maintenance do you offer after the project is completed and how does it meet business needs? Arrow right

    After the rescue phase, just like after normal software development, ongoing support ensures your software remains stable and continues to meet business goals. At Syndicode, maintenance and support services include monitoring, performance optimization, bug fixes, and regular updates. You can also extend the partnership for new feature development or technical consulting. The idea is to maintain progress, prevent old technical challenges from resurfacing, and support your team as the product evolves.
